Want a Grid Connection? UK Data Centers May Soon Have to Pay First
Introduction: A Place in the Queue Is No Longer Free
For years, securing a grid connection in Britain largely meant joining a queue.
Developers submitted applications, reserved future network capacity and waited—sometimes for more than a decade—for the electricity infrastructure needed to support their projects.
That system is now under pressure.
On July 29, 2026, UK energy regulator Ofgem proposed a new data centre commitment fee intended to remove speculative, stalled and commercially unviable projects from the grid connection queue.
Under the proposal, data centre developers could be required to pay between £237,500 and £712,500 per megawattof requested capacity. The payment would be refunded when the facility is successfully enerGISed, but it could be forfeited if the project withdraws or fails to meet agreed development milestones.

Key Takeaways
1. Why Britain Is Changing the Grid Connection Rules
The scale of Britain’s connection queue has become difficult to reconcile with actual electricity demand.
Ofgem’s proposal follows a rapid increase in large-load connection requests, driven primarily by data centres. Projected electricity demand in the connection pipeline reportedly increased from approximately 41 GW in November 2024 to 125 GW by June 2025, with data centres accounting for at least 80 GW.
Not all these projects will be built. Some lack planning permission, some have not secured financing, and others may be reserving capacity while developers search for investors, customers or suitable land.
Every speculative project occupying a place in the queue can delay another project that is ready to proceed—a hospital, industrial facility, housing development, EV charging hub or fully financed data centre.
A developer would no longer prove seriousness with an application alone. It would need to put meaningful capital at risk.

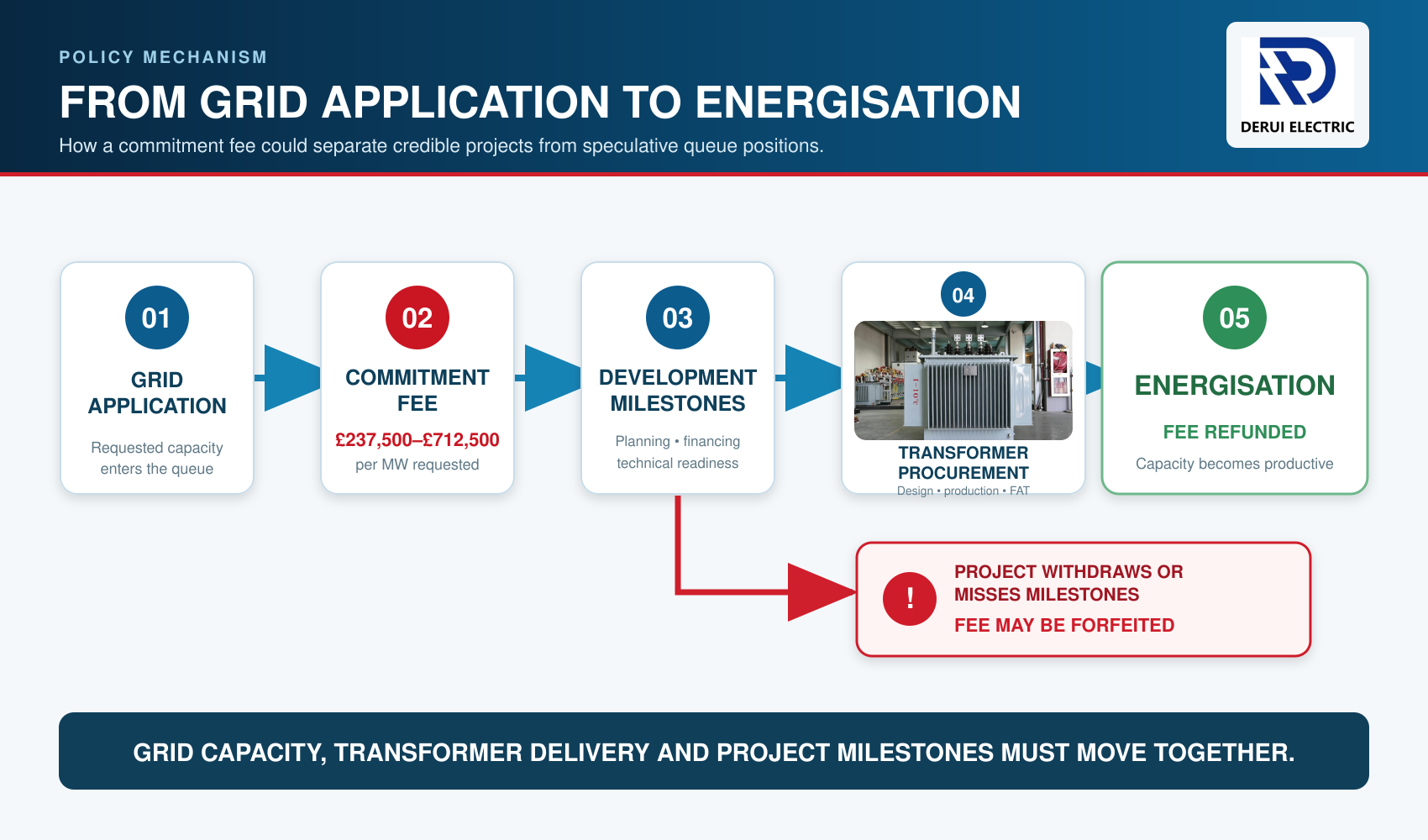

2. How the Data Centre Commitment Fee Could Work
The concept is relatively simple. A data centre developer requesting a grid connection would pay a fee linked to the amount of electrical capacity it wants to reserve.
The proposed range is equivalent to approximately 2.5% to 7.5% of average project costs, depending on the final structure. A hyperscale development could therefore face a financial commitment measured in tens or even hundreds of millions of pounds.
| Project Outcome | Possible Fee Treatment | Purpose |
|---|---|---|
| Project reaches enerGISation | Fee refunded | Rewards credible project delivery |
| Project withdraws | Fee may be forfeited | Discourages speculative applications |
| Milestones are missed | Capacity position may be reviewed | Keeps the connection queue moving |

3. A Grid Connection Is Only One Part of Project Readiness
A financial deposit may help Ofgem identify serious developers, but money alone does not make a data centre ready for enerGISation.

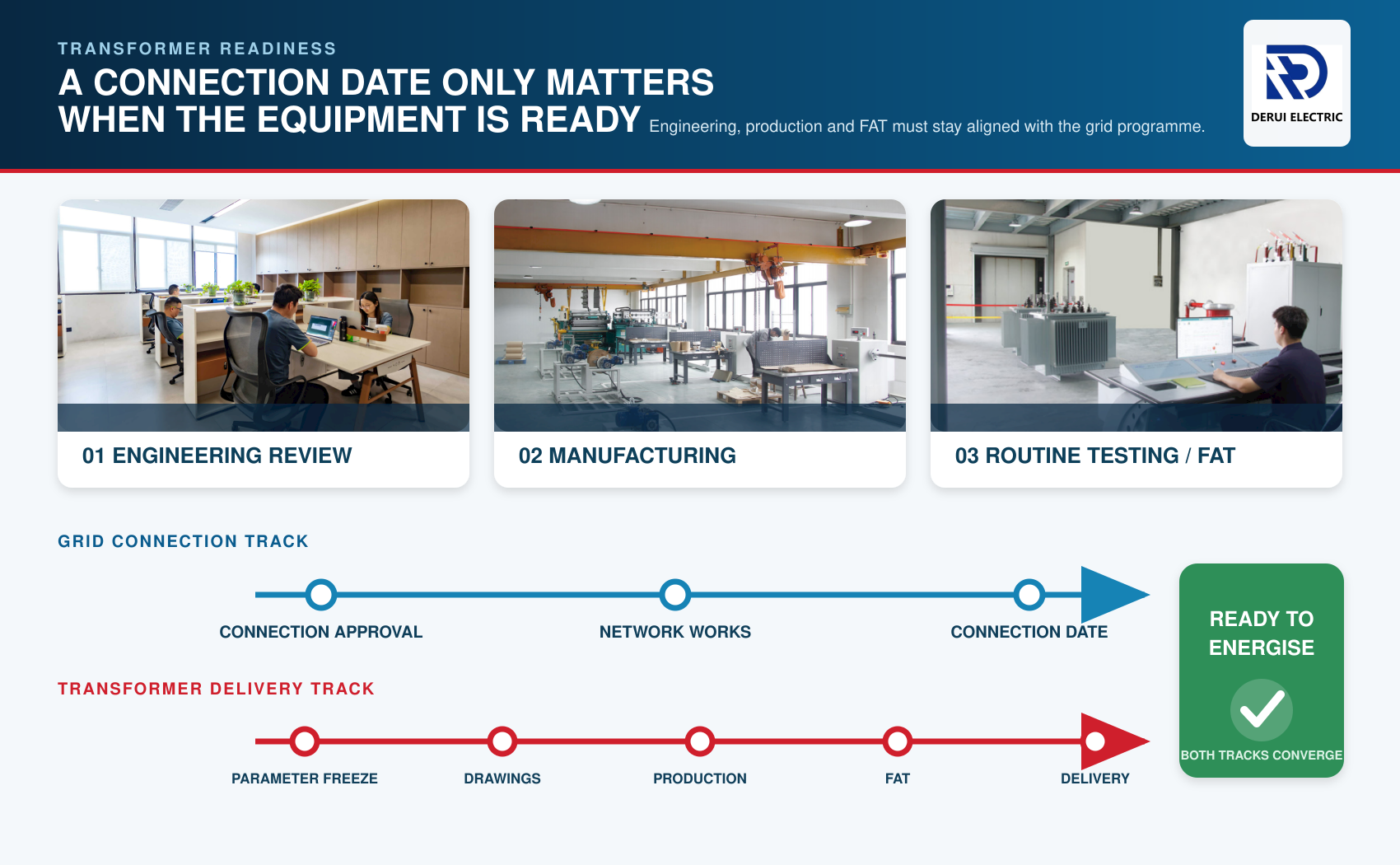

The project must also demonstrate that its electrical infrastructure can actually be designed, manufactured, tested, delivered and commissioned.
Large power transformers are manufactured according to project-specific electrical and mechanical requirements. Voltage ratio, impedance, vector group, loss guarantees, insulation level, cooling arrangement and installation conditions must be reviewed before production can proceed.
4. Why Transformer Procurement May Move Even Earlier
The proposed UK rules create a stronger incentive for developers to prove that their projects are genuinely deliverable.
Under a system involving financial commitments and progress milestones, delays in electrical design or transformer procurement could place both the construction schedule and the connection fee at risk.
Transformer Capacity
The selected rating must reflect initial IT demand, auxiliary loads and future expansion without creating unnecessary oversizing.
Voltage and Grid Interface
Primary voltage, secondary voltage, earthing arrangement and utility requirements must be coordinated with the network operator.
Redundancy Strategy
N+1, 2N and other resilient architectures can require multiple transformers, separate feeds and carefully coordinated protection.
Efficiency and Loss Guarantees
No-load and load losses become significant operating costs in facilities running continuously throughout the year.
Delivery and FAT Schedule
Drawing approval, production, Factory Acceptance Testing, shipment, installation and commissioning must align with the grid connection milestone.

5. A New Definition of a “Ready” Infrastructure Project
The Ofgem proposal reflects a wider shift in how grid operators evaluate major electricity users.
| Traditional Readiness | Emerging Readiness Requirements |
|---|---|
| Land secured | Confirmed electrical infrastructure plan |
| Planning application submitted | Credible equipment delivery programme |
| Financing discussed | Transformer and substation availability reviewed |
| Connection application submitted | Milestone-based construction and commissioning schedule |
For developers, an unrealistic equipment schedule could jeopardise much more than commissioning. It could also threaten the project’s position in the grid connection queue.
6. What Procurement Teams Should Do Now
Start transformer discussions during feasibility
Early technical engagement allows preliminary capacity, voltage, redundancy and installation conditions to be reviewed before the specification is frozen.
Freeze critical parameters first
Capacity, voltage ratio, impedance, cooling method, loss requirements and environmental conditions should be agreed before secondary accessories.
Request an order-specific delivery assessment
The delivery schedule should reflect current capacity, material readiness, long-lead components and testing availability—not a generic brochure estimate.
Align FAT with the connection programme
FAT, shipment release, site installation and commissioning should be included in the master grid connection schedule.
Confirm the future expansion strategy
Phased projects should consider future transformer capacity and substation layout without creating unnecessary first-stage capital expenditure.
7. What We Are Seeing From the Manufacturing Side
One change we have observed in recent transformer inquiries is that buyers increasingly ask about delivery feasibility before their final specifications are complete.
They want to know:
- Whether manufacturing capacity is currently available;
- Which transformer parameters must be frozen first;
- Whether delivery can match the grid connection schedule;
- Whether FAT can be witnessed in person or remotely;
- How future project phases can be incorporated into the initial design.
This reflects a broader change in transformer procurement. The transformer is no longer simply an equipment package ordered after civil construction begins. It is becoming part of the project’s earliest commercial and scheduling decisions.
At Derui Electric, we support this process through preliminary technical review, project-specific delivery assessment, production progress updates and witnessed FAT arrangements. The objective is not to promise an unrealistic date, but to establish a schedule that developers, EPC contractors and grid connection teams can plan around.
8. What the Proposal Could Mean Beyond Data Centres
Although Ofgem’s proposal focuses on data centres, the underlying principle could eventually influence other large-load developments.
Battery manufacturing plants, hydrogen facilities, EV charging hubs and electrified industrial sites also require significant grid capacity and major transformer infrastructure.
As electricity demand rises, grid operators may increasingly prioritise projects that demonstrate:
Conclusion: Grid Capacity Must Be Earned, Not Just Reserved
Ofgem’s proposed commitment fee marks a significant change in the relationship between project developers and the electricity grid.
A connection application may no longer be enough. Developers could be required to prove that their projects are financed, progressing and technically capable of reaching energisation.
Need a Transformer Delivery Assessment for Your Project?
Send us your preliminary capacity, voltage, redundancy and installation requirements. Our engineering team will help review the critical parameters and provide a realistic project-specific delivery assessment.
Contact Derui ElectricEngineering support · Project-specific quotation · FAT witnessing · Transparent production updates
Frequently Asked Questions
What is the UK data centre commitment fee?
It is a proposed financial commitment linked to requested grid connection capacity. The payment would generally be refunded when the project reaches energisation but could be lost if the project exits the queue or fails to progress.
Has the fee already taken effect?
No. Ofgem has proposed the measure for consultation. The final fee structure, milestones and implementation requirements may change.
Why are speculative grid applications a problem?
They can reserve limited network capacity even when projects lack planning permission, financing or a realistic construction schedule, potentially delaying more mature developments.
Why does this affect transformer procurement?
A project cannot reach energisation without transformers and associated substation equipment. Long design, manufacturing and testing cycles mean these assets must be planned early.
Should developers order transformers before final grid approval?
Developers should at least begin technical engagement, confirm critical parameters and obtain a realistic delivery assessment. The timing of a binding order depends on connection certainty, project financing and contractual risk allocation.
Sources and Further Reading
- Ofgem — Proposed measures addressing unviable, stalled and speculative data centre projects, July 2026.
- Reuters — UK Ofgem proposes grid-connection commitment fee for data centres, July 29, 2026.
- UK Government — Reforms addressing speculative demand grid connection requests.
- National Energy System Operator — UK connections reform programme and results.
